Frest HomesMMC · for business
Frest Homes · MMC

We design buildings that are made in factories.

Frest is a design-and-build company with its roots in timber-frame homes. For other businesses we do the part that decides whether offsite works: production, structural, technical, architectural and MEP design, checked against the factory before a single element is made.

557hospital bathroom PODs designed, Copenhagen
35POD types in one hospital, each drawn in full
102modules and PODs in one apartment building, Reykjavík
1 · 2 · 5 · 7MMC categories we design for
Completed projects · Norway, Sweden, Denmark

Ten projects, built from factory-made elements.

Apartments, row houses and private homes our team produced and built for developers and contractors, with design where marked. Swipe through, then open any project for the full set of photos.

Vallastaden, Linköping · Sweden

7 floor CLT, 121 apartments

ProductionStructural designBuild

Read about the project ↗
Henningsvær · Norway

7 apartment houses on the quay

ProductionBuild

Kolvereid · Norway

3 floor apartments

ProductionBuild

Asker · Norway

4 apartment blocks

ProductionBuild

Eidsvoll · Norway

6 apartment row

ProductionBuild

Danderyd · Sweden

7 row houses

ProductionBuild

Anevegen · Norway

2 twin houses

ProductionBuild

Als · Denmark

8 private homes

ProductionDesignBuild

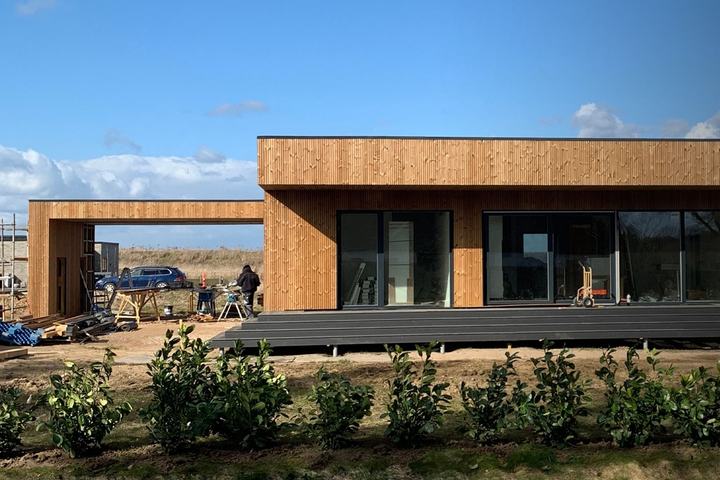

Middelfart · Denmark

Energy+ private house

ProductionDesignBuild

Alster · Sweden

Single family house

DesignProductionBuild

Swipe or use the arrows to see every project. Tap a photo or See all photos to open the full set.

Three words, one method

Offsite is where. MMC is how it is built. MMD is how it is designed.

OFFSITEwhere

OffsiteManufacturing away from the site

Building elements are made in a factory, in the dry, to millimetre tolerances, then transported and assembled. The site becomes an assembly place.

  • Panels, modules and pods made indoors
  • Foundations built in parallel with production
  • Shorter, quieter, safer time on site
MMChow it is built

Modern methods of constructionOffsite and more

MMC covers seven categories, from volumetric modules to digital site processes. Offsite manufacturing is the largest part of MMC, but not all of it.

  • Category 1: 3D modules
  • Category 2: 2D panels
  • Category 5: pods and assemblies
  • Category 7: digital site process
MMDhow it is designed

Modern methods of designAI-assisted, human-approved

A factory cannot fix a drawing that is wrong. MMD is our name for designing with AI-assisted tools that check, compare and draft, while the project team keeps every decision.

  • Developed with Frest Consult, our AI subsidiary
  • The ring and string method
  • Local models where the data is sensitive
The MMC definition framework

Seven categories. We design for the ones that need the most drawing.

The seven categories come from the MMC definition framework used in the UK and Ireland. Pick one to see what it means and where Frest works in it.

Category names follow the MMC definition framework (MHCLG, 2019). Bathroom pods are classed in category 5 as non-structural assemblies.

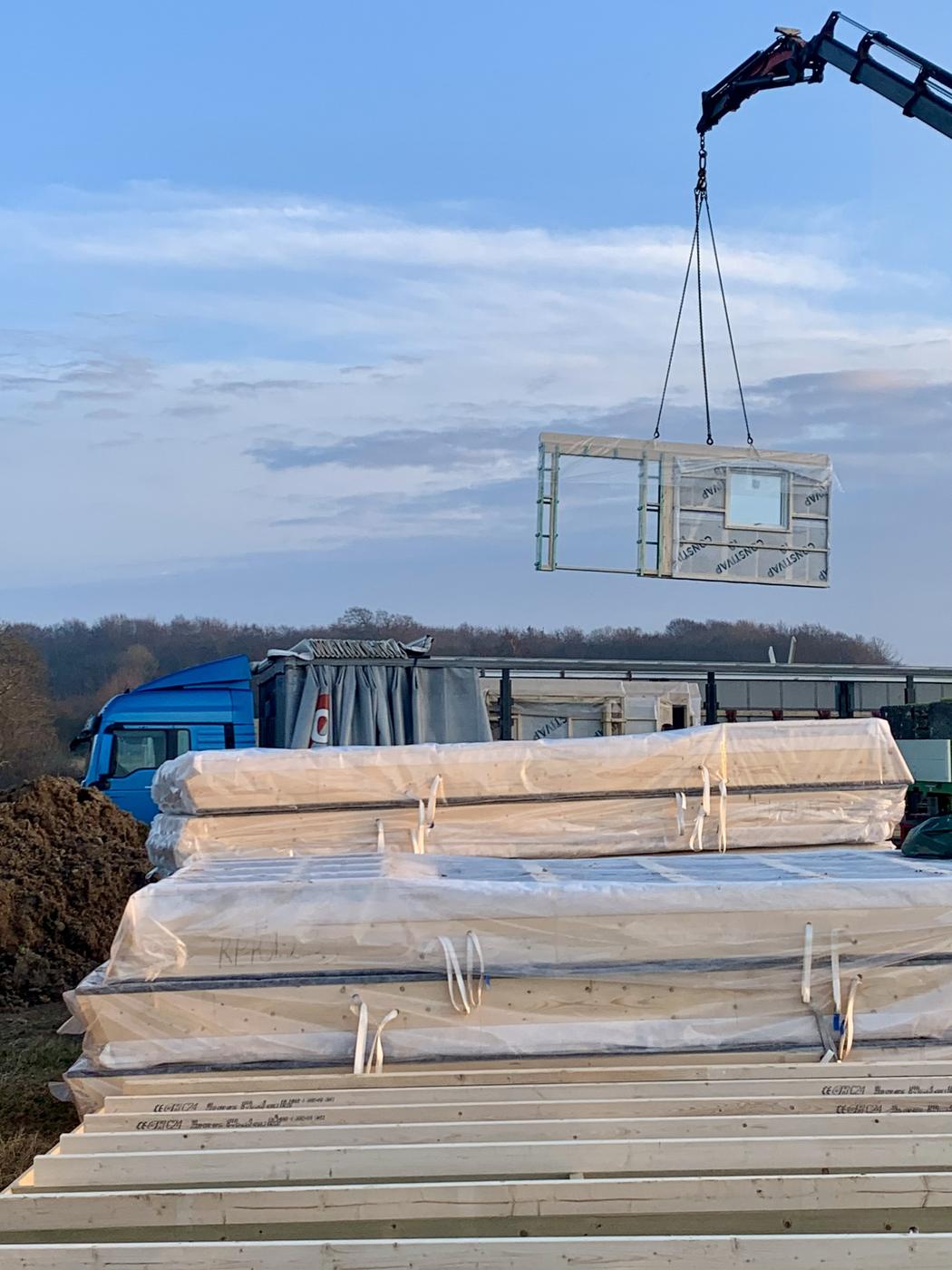

A wall panel lifted from the truck to the slab
Chapter 01 · ProjectsDenmark · Iceland · Latvia

The factory builds it once. We draw it first.

Six projects where Frest carried the design between the building designer and the factory: types, quantities, models and production drawings.

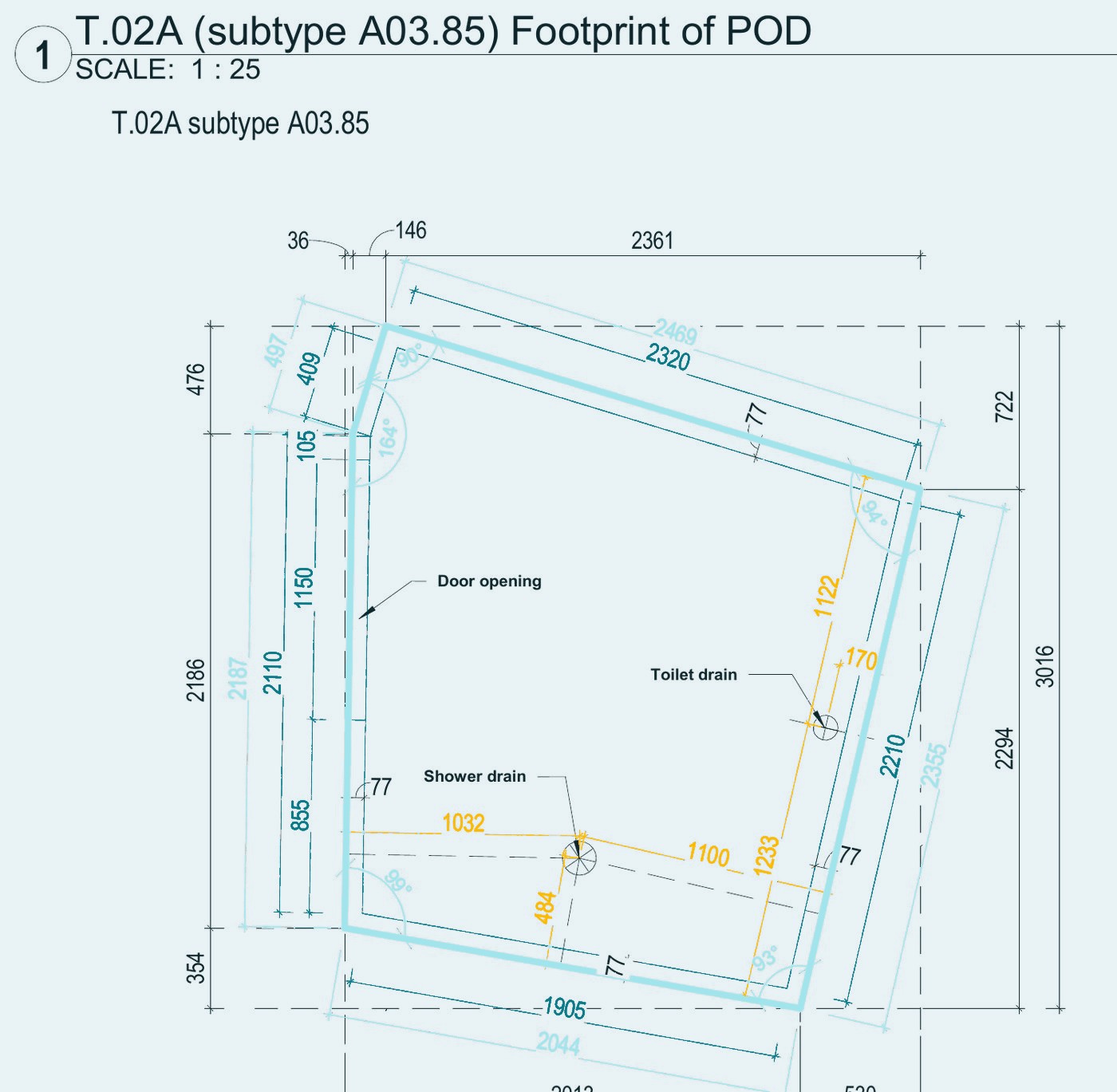

Case 01 · Category 5 · Healthcare · 2022 – 2024

557 bathroom PODs for a new hospital in Copenhagen.

New Hospital Bispebjerg · Bispebjerg Bakke 23 / Elise Sørensens Vej 1 · 2400 København NV

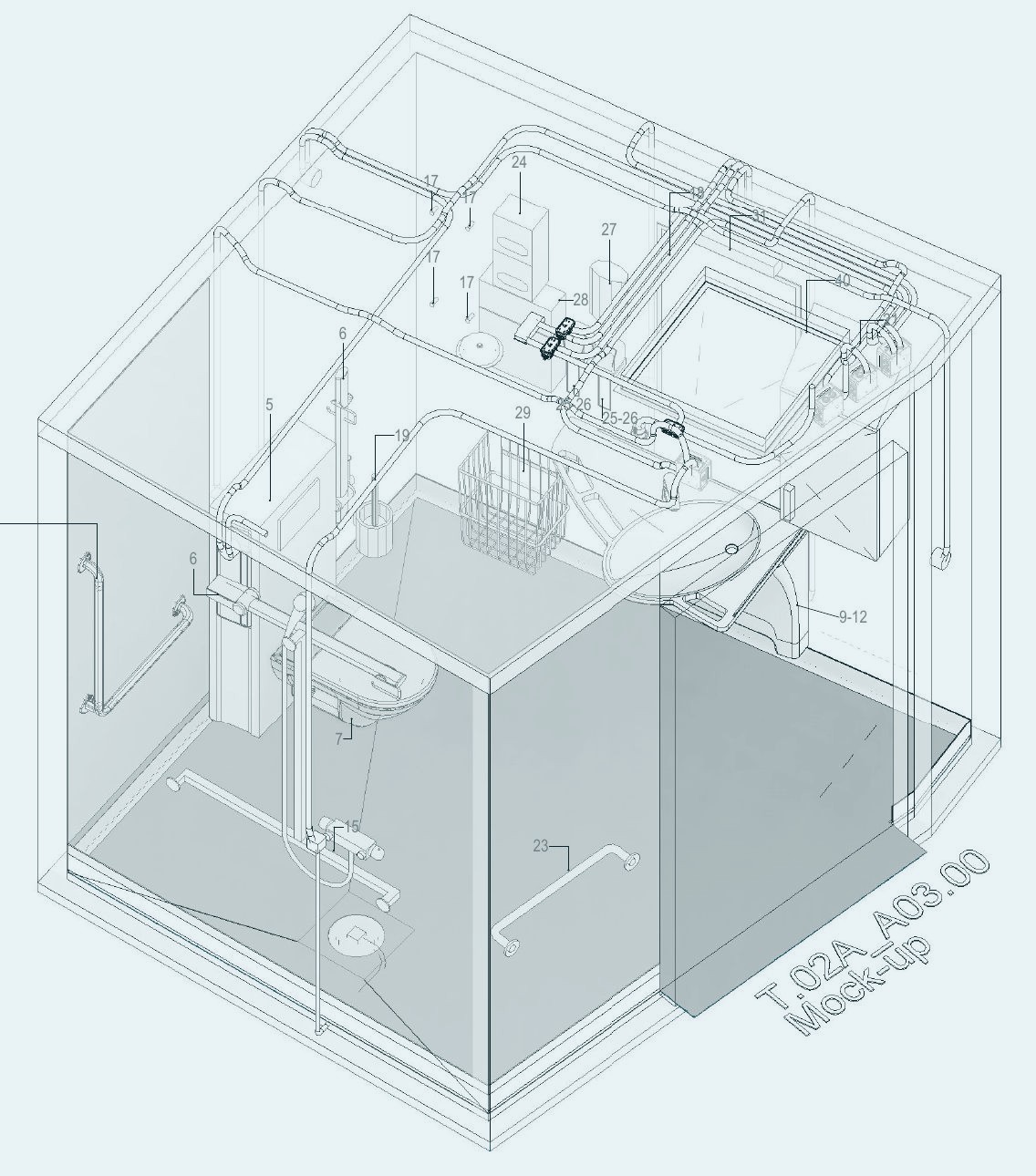

Six buildings, hundreds of patient and staff bathrooms, each one arriving as a finished POD: walls, floor, ceiling, vinyl, sanitary ware, lighting and accessibility equipment installed in the factory. Frest designed the PODs type by type, from the room data sheet to the shop drawing, with the quantities and the model the factory produced from.

PODs
483 + 74 optional
POD types
35
Gross POD area
3 530 m²
Largest envelope
4 680 × 2 724 × 2 845

Click a drawing to open it full size

Where the quantity sits

Two types make up 416 of the 483 base PODs. The other 33 types are where the design hours go: each is drawn, quantified and checked as fully as the largest.

WALLS · IW-01 77 mm

Steel CW50 studs, two layers of 12.5 mm moisture-resistant gypsum, vinyl on the bathroom side, timber noggins behind every grab rail. Acoustic wall between two bathrooms above Rw 48 dB.

FLOOR · FL-02 55 – 85 mm

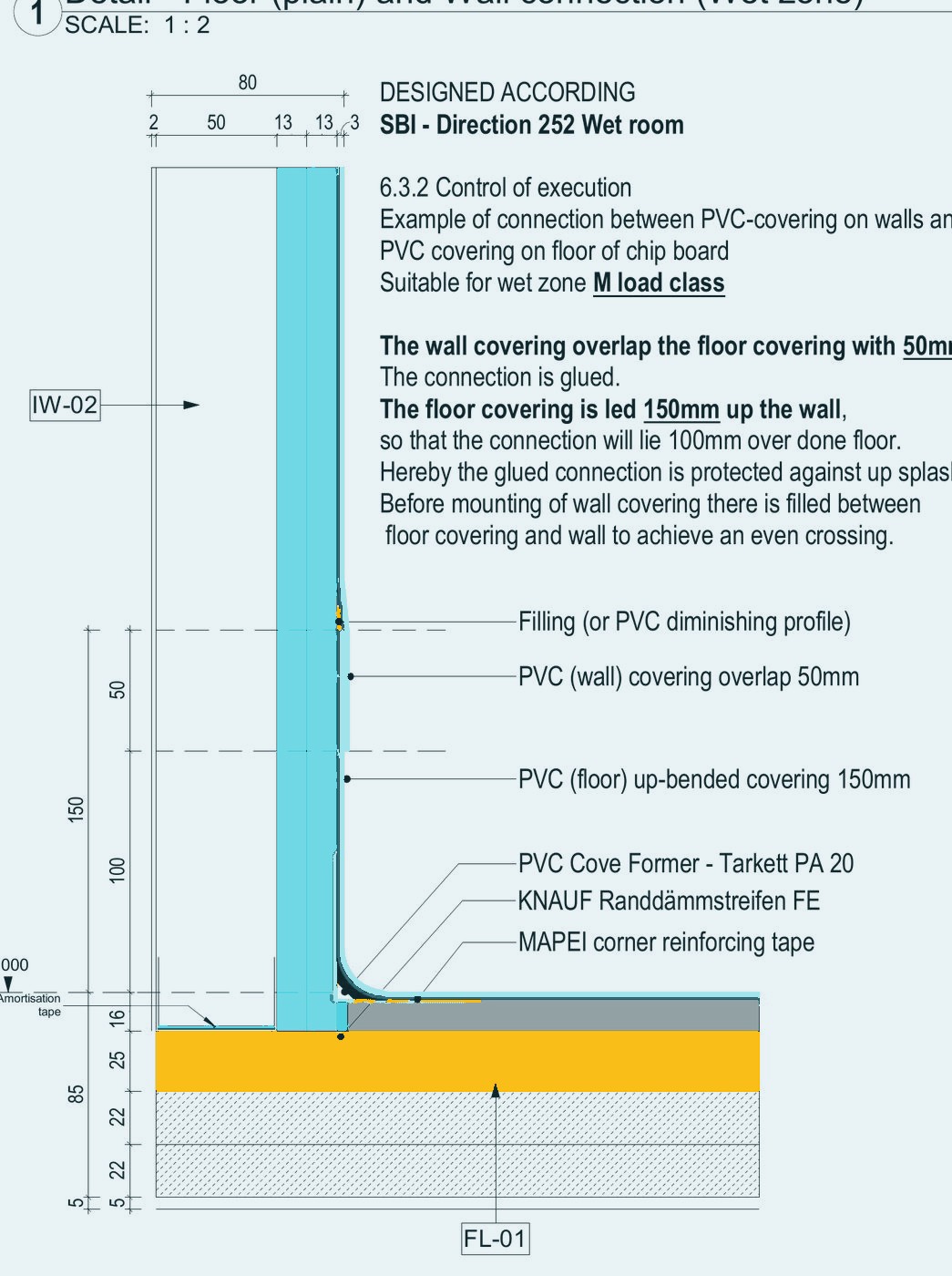

Two layers of 22 mm particle board, sloped levelling to the drain, safety vinyl turned 150 mm up the wall, EPDM mat underneath. Class M wet room to SBi 252.

SERVICES

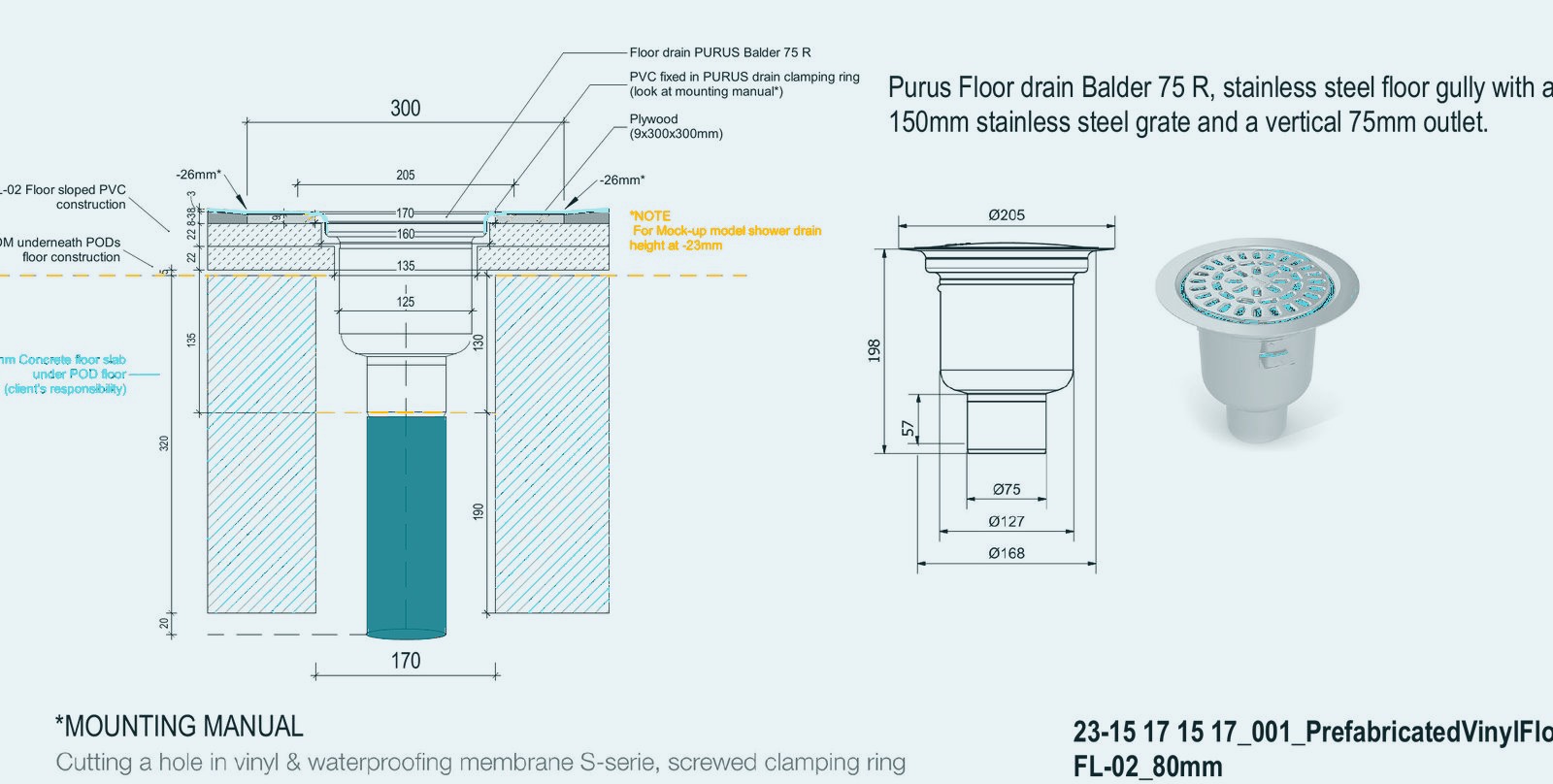

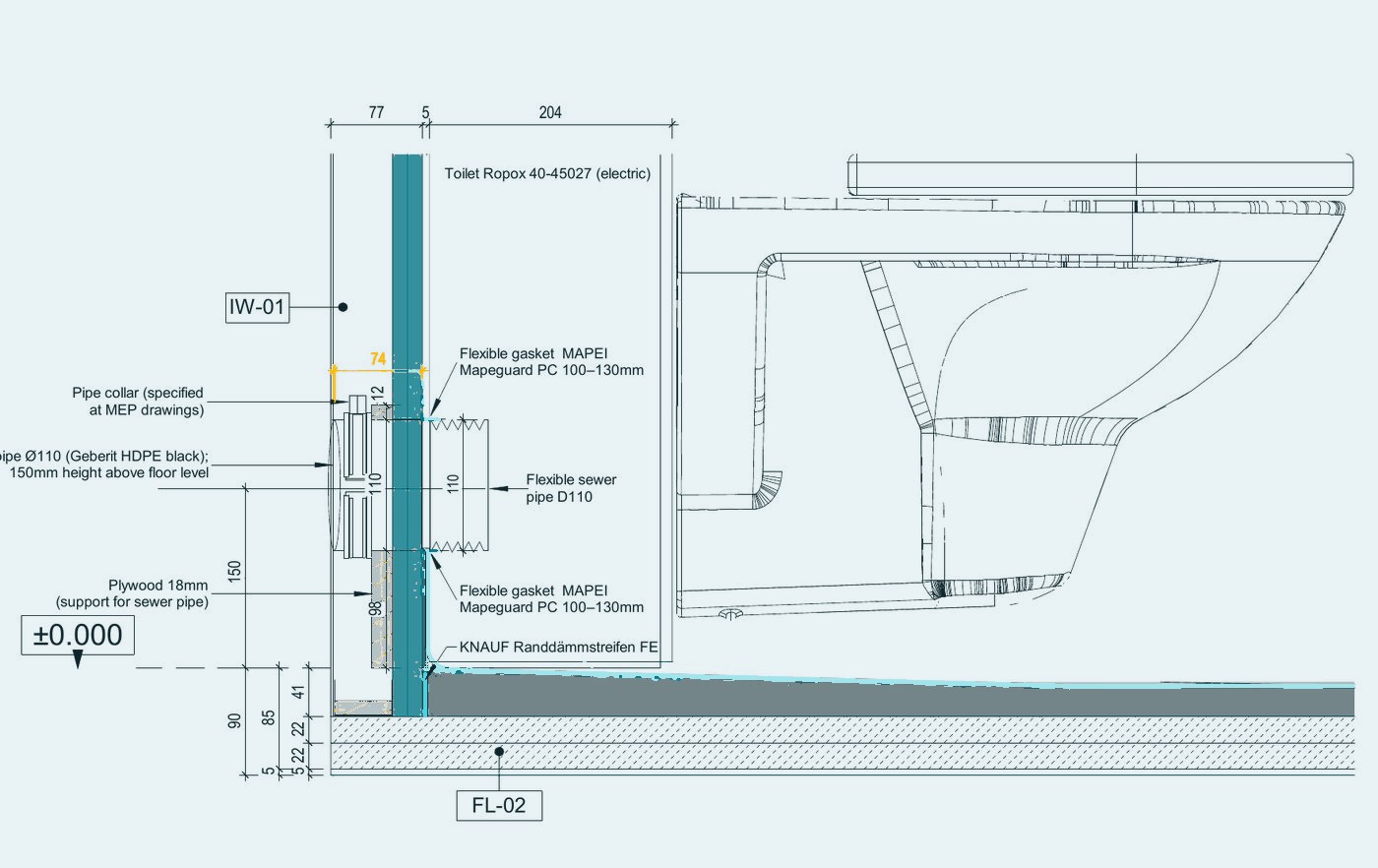

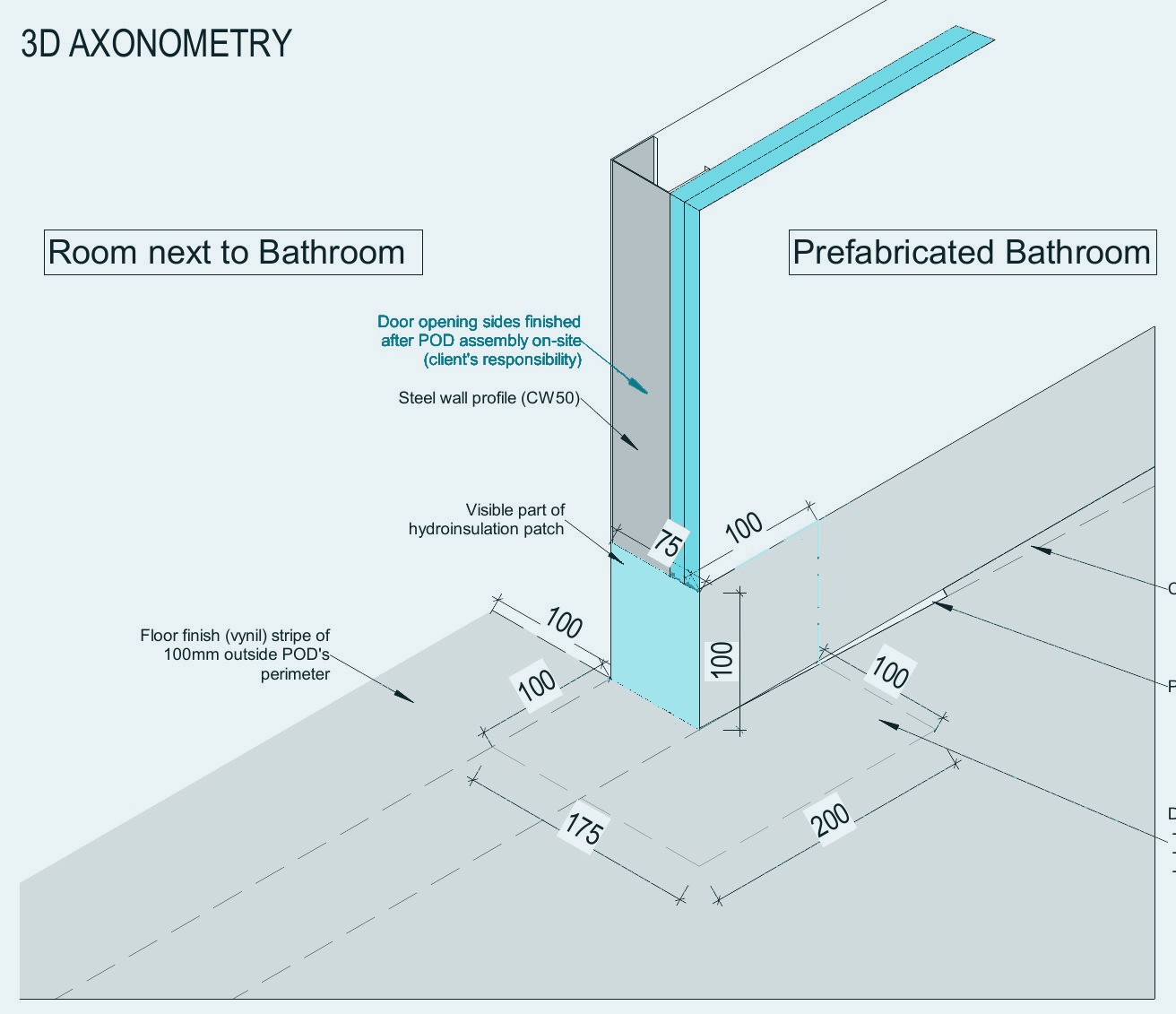

Water supply inside the prefabricated walls, ventilation to the main duct above the ceiling, a 57 mm ceiling opening left for every sprinkler nozzle.

Case 02 · Categories 1 and 5 · Residential · 2022 – 2023

A five-storey modular apartment building in Reykjavík.

Skúlagata 30 · 101 Reykjavík · Iceland

Apartments and hotel rooms along a central corridor, built from steel-framed volumetric modules finished inside in the factory, with bathroom PODs, kitchenettes and built-in furniture. Frest carried the architectural design of the modular part: module and POD types, modularisation plans for every level, wall types, interiors and quantities, to Icelandic loads and standards.

Modules + PODs
65 + 37
Modular area
≈ 2 070 m²
Module envelope
11 769 × 4 110 × 3 060
Modular storeys
5 north · 4 south

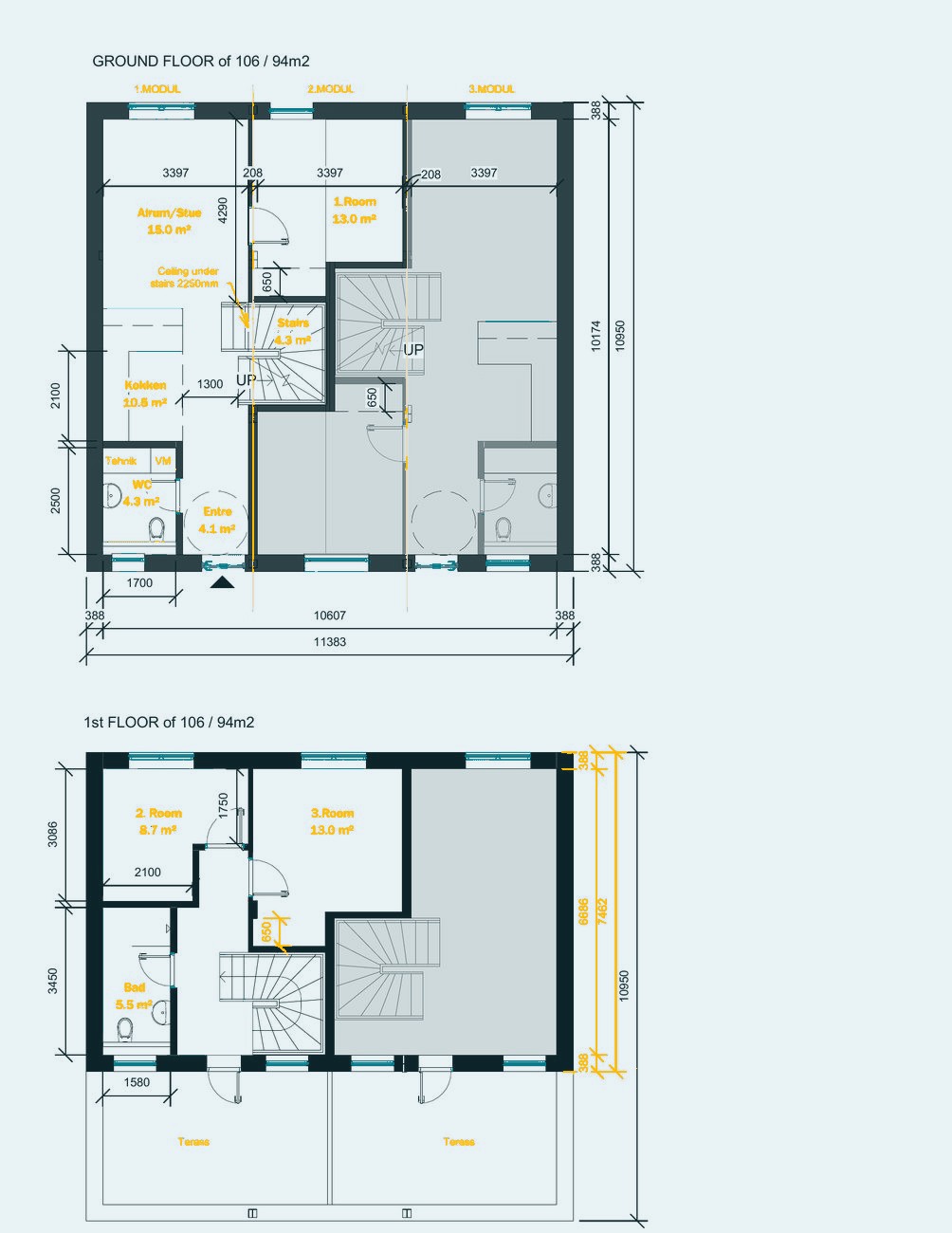

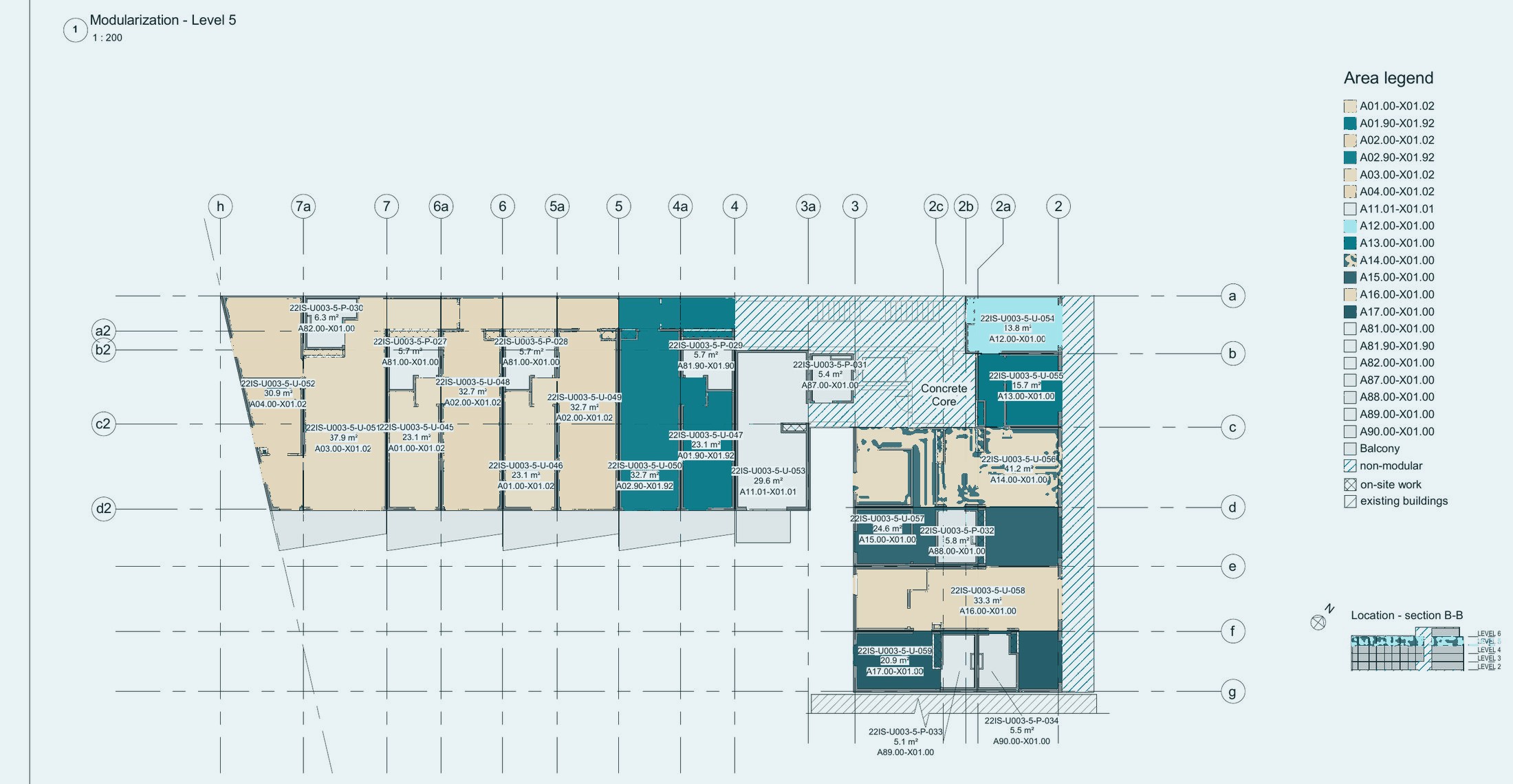

Level 5 split into modules, each tagged with its type, area and position on the grid. The hatched zone is the concrete core and the existing building, built on site.

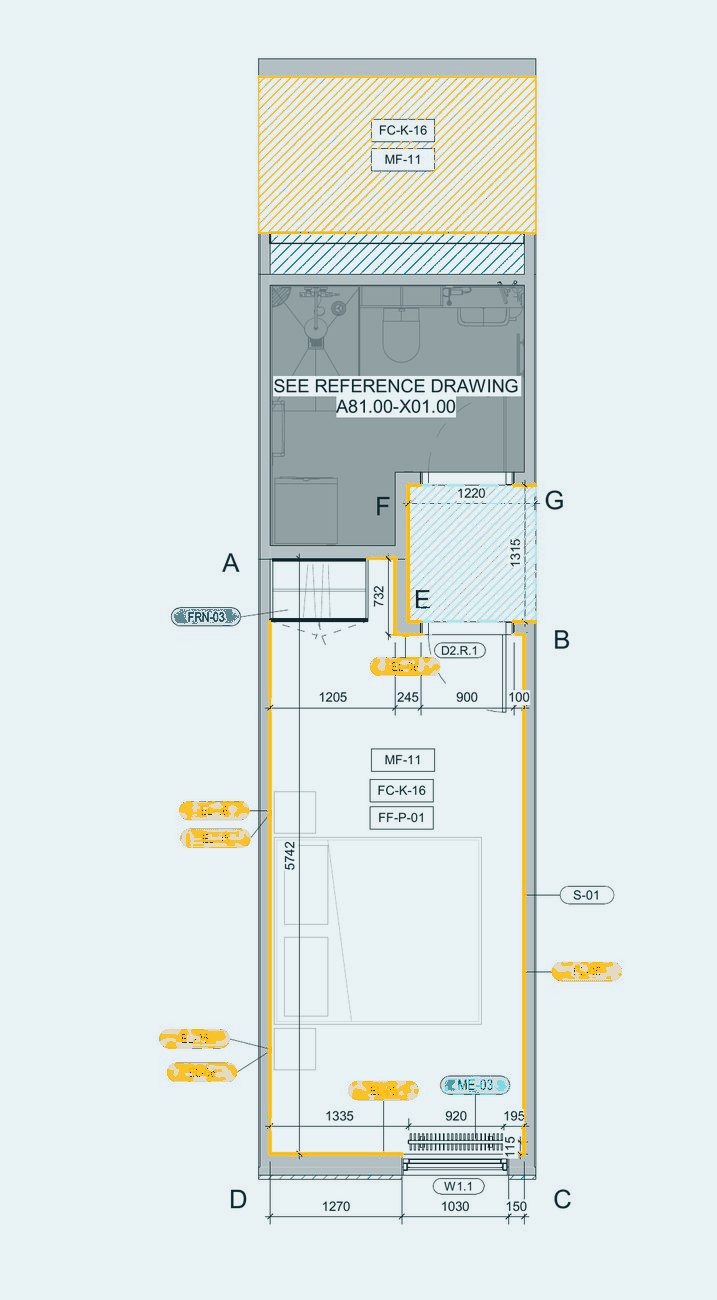

One module type, drawn to the last socket.

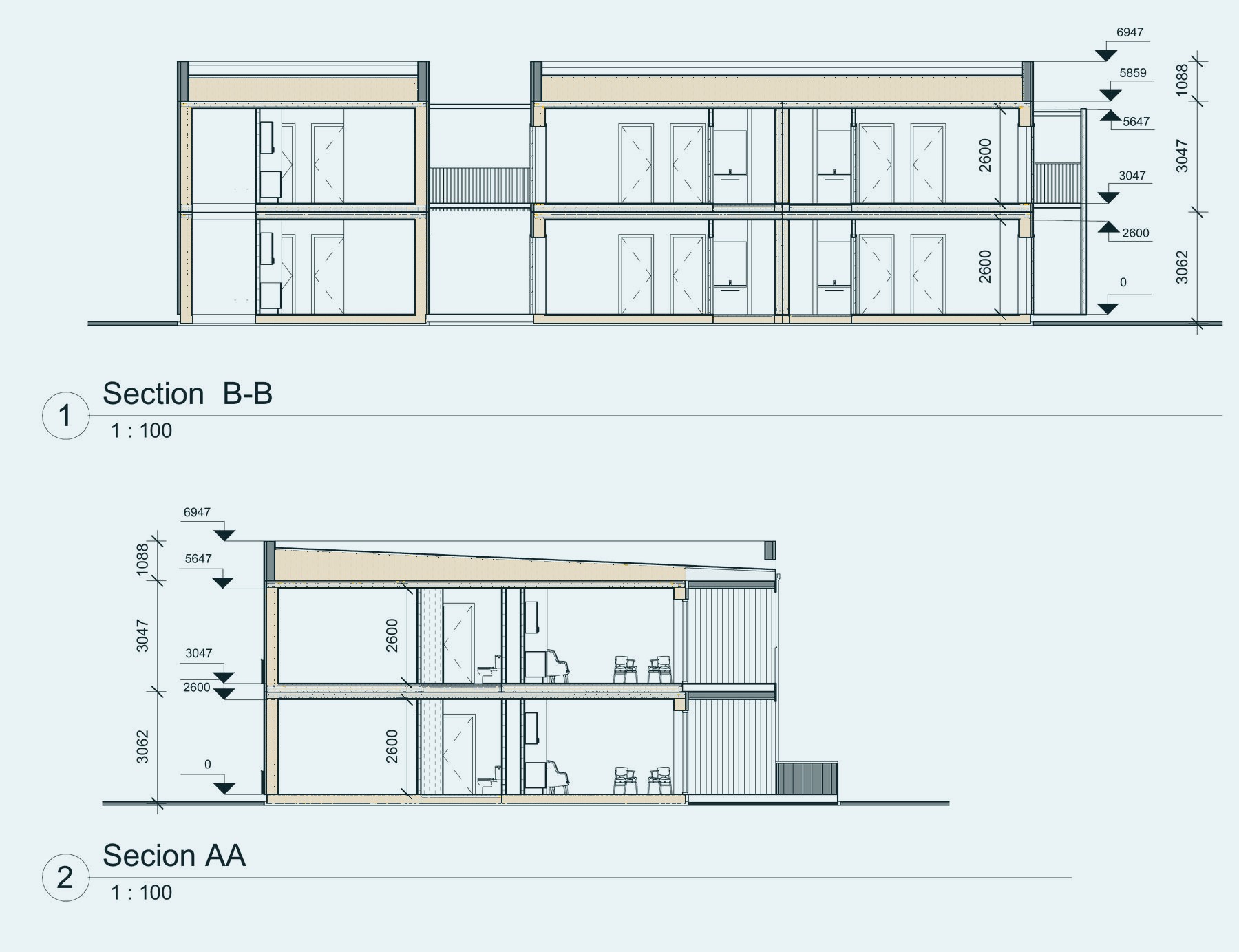

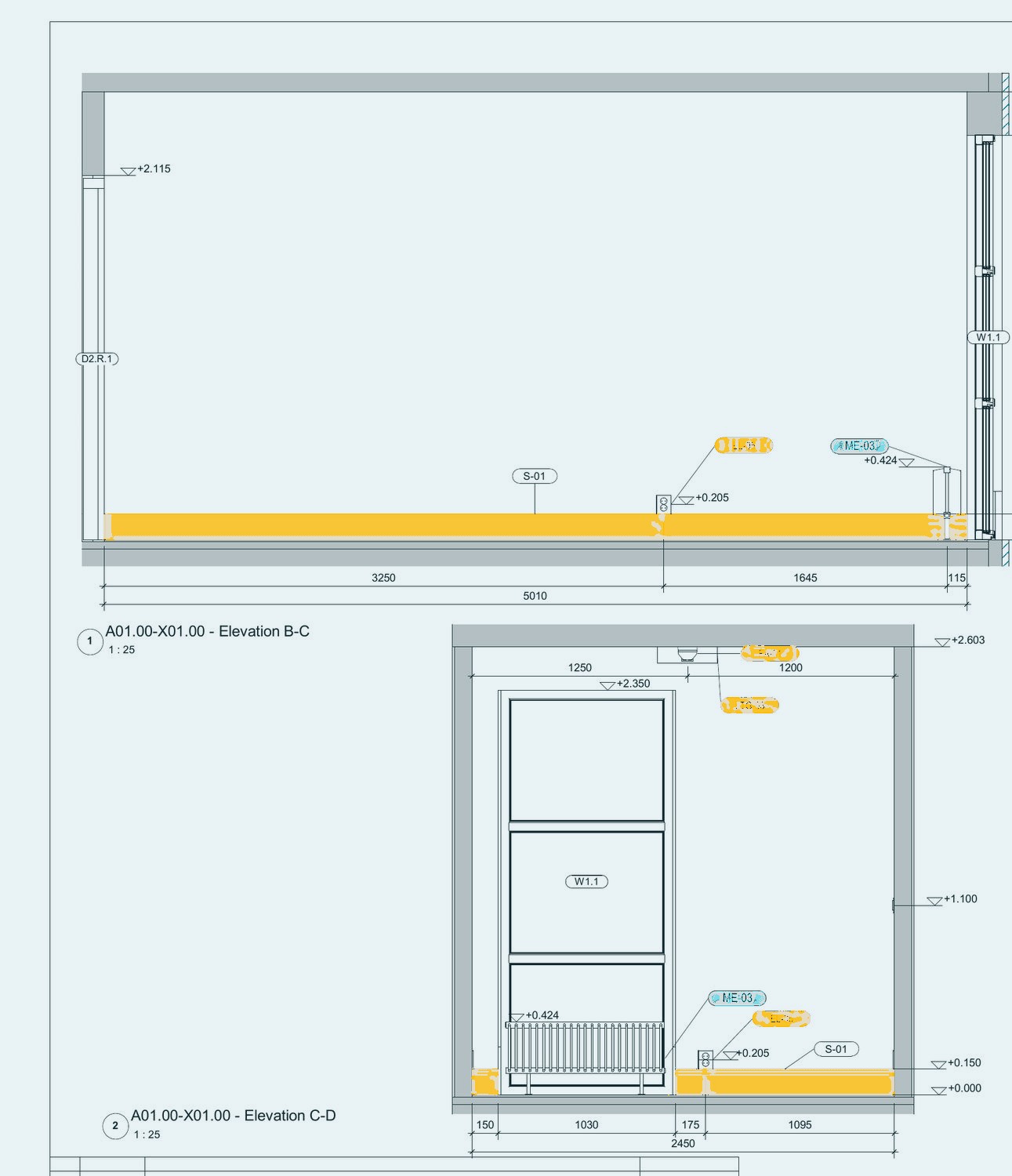

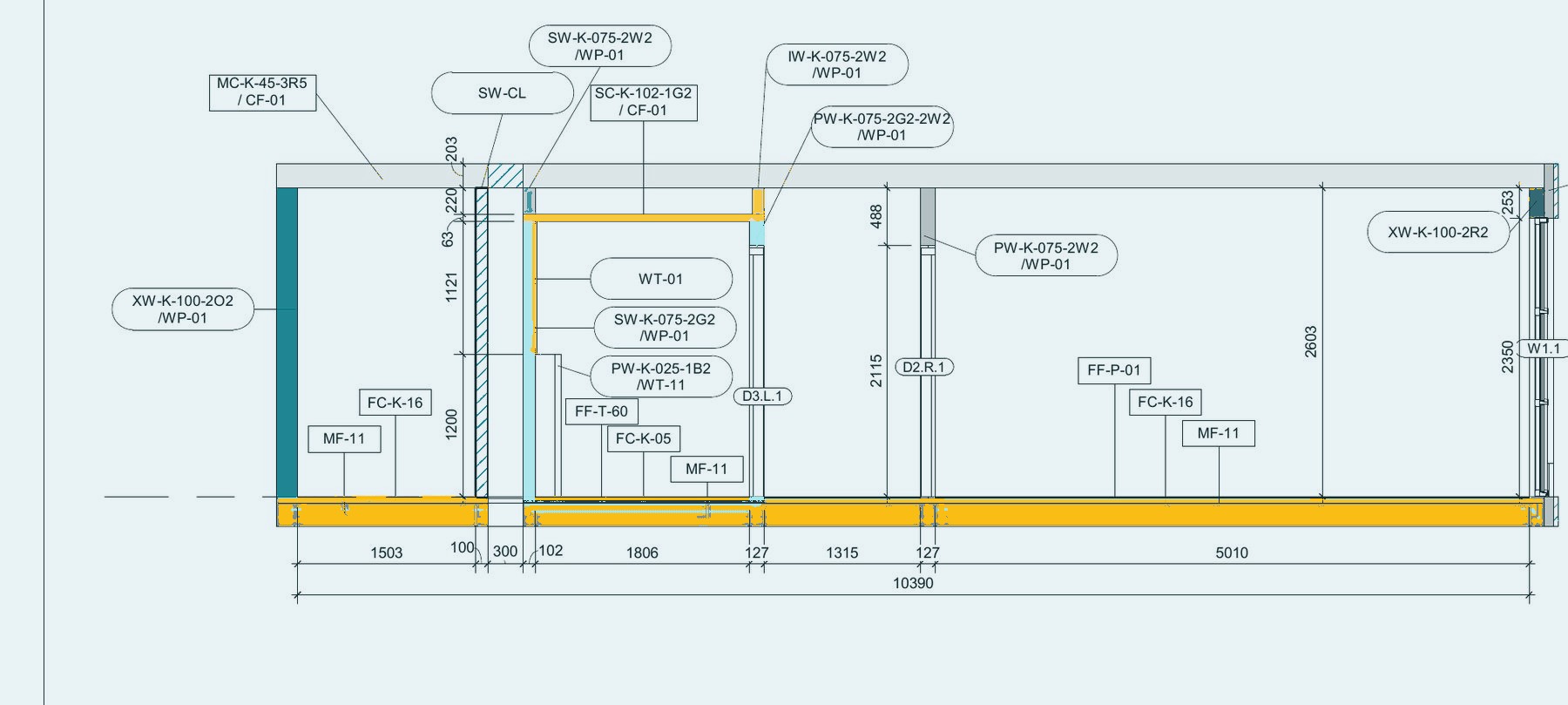

Module A01.00 is a 10.4 m bedroom module with its bathroom POD at the corridor end. Its drawings give every wall type, finish, fixture, socket and radiator, so the factory can finish it completely before it travels.

Load-bearing structure, all floorsREI 90
Apartment to hallwayEI 60
Wall to existing buildingREI 120
Apartment entrance doorEI 30-CS
Sound, wall between apartments55 dB
Sound, apartment to hallway53 dB
Case 03 · Category 2 · Panelised timber frame · 2021 – 2022

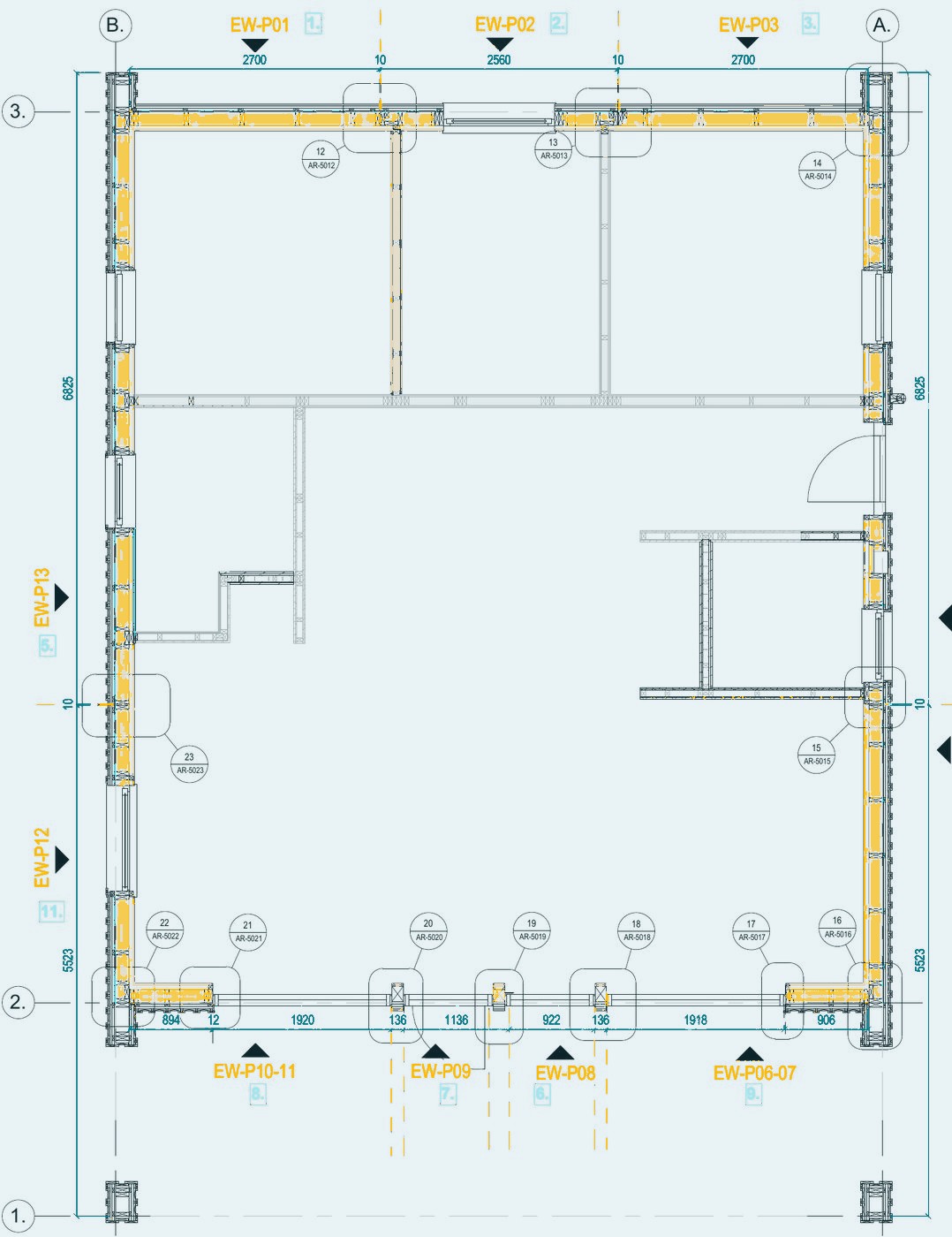

Eight Als homes in Kettingskov, drawn panel by panel.

Kettinge Skov · Havmose · Als · Denmark

For the Als village we issued a production set for every wall, floor and roof panel, and the order to put them up on site. House C alone has 13 external wall panels, numbered in the sequence the crane lifts them.

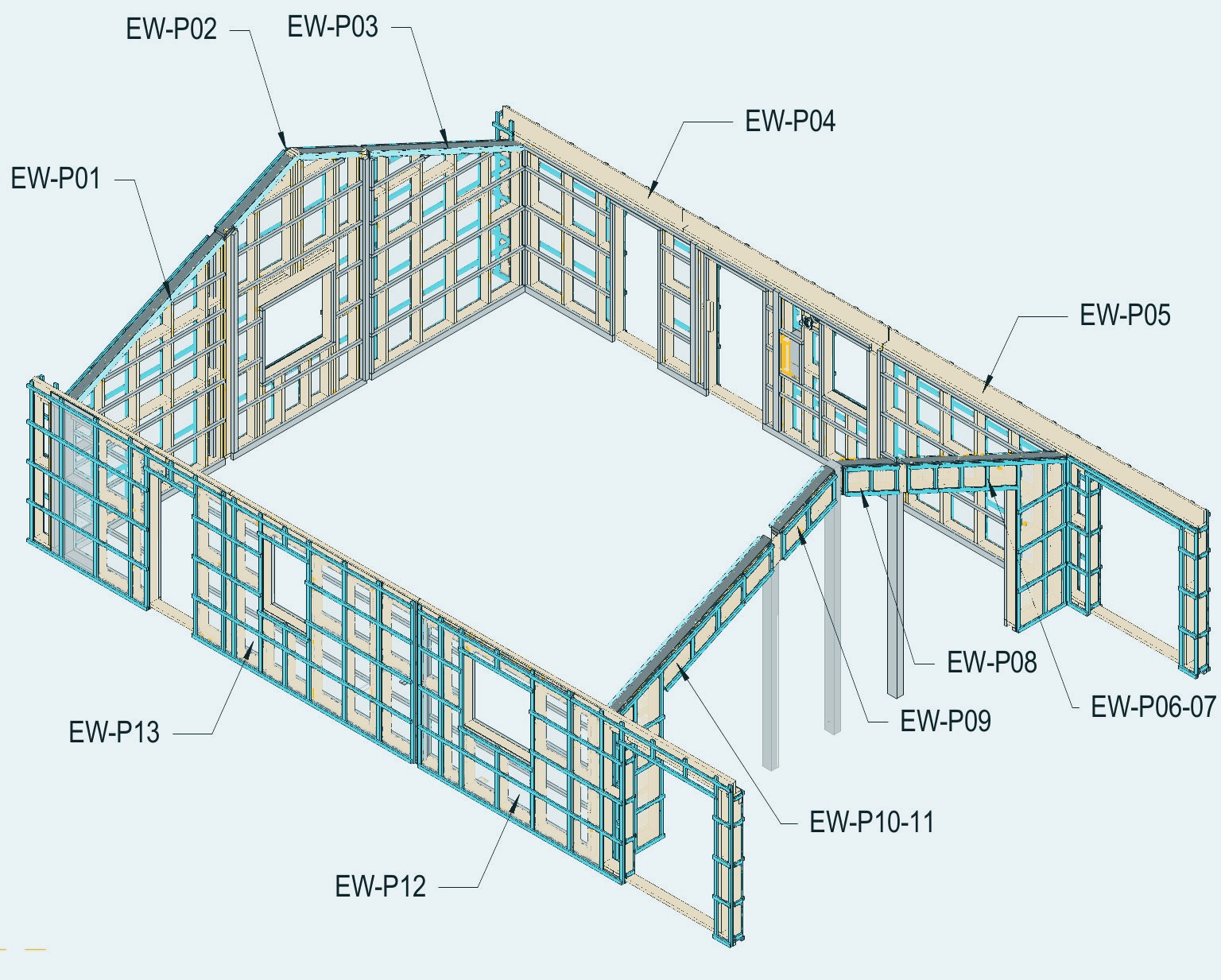

One wall, joint by joint.

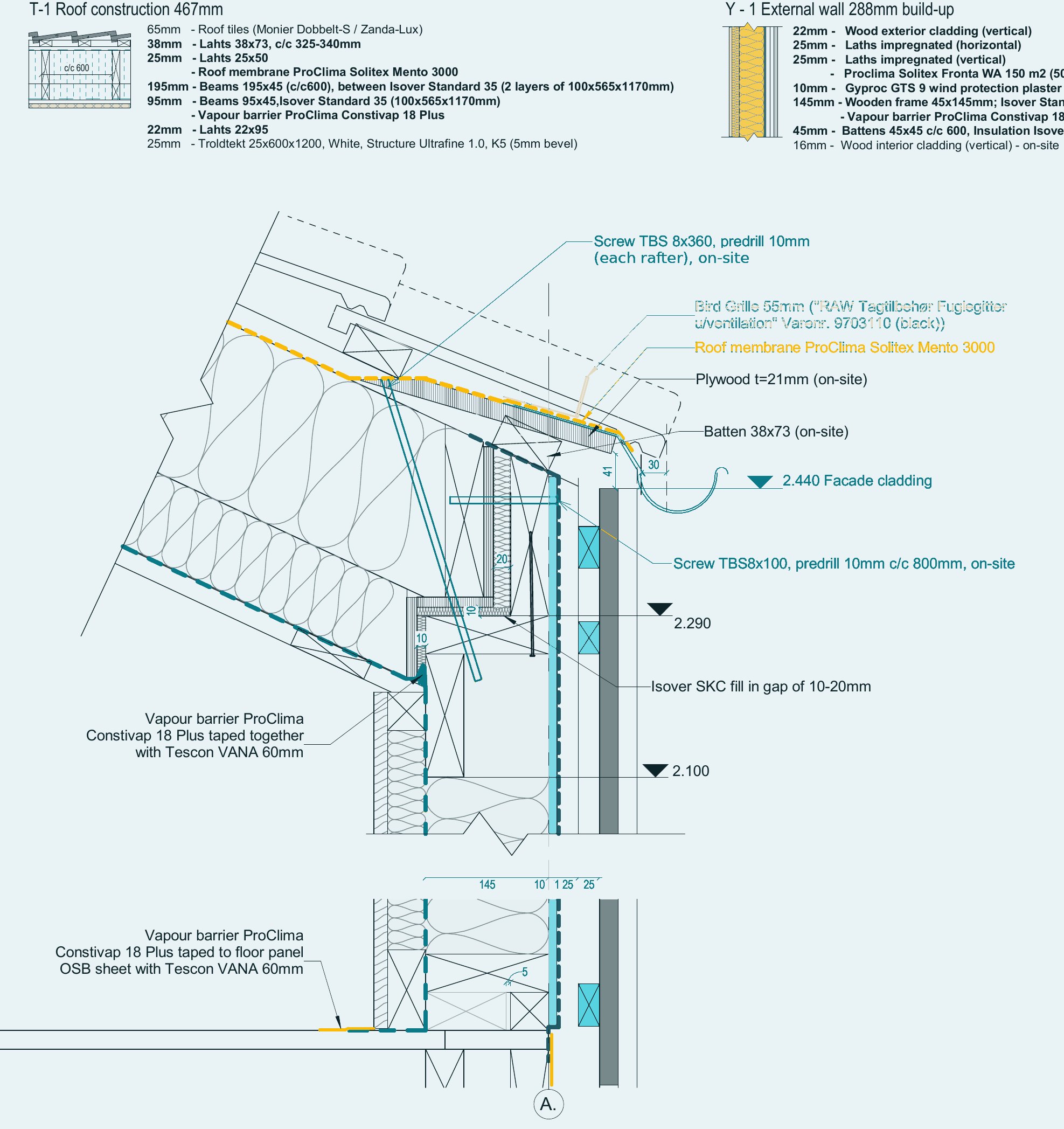

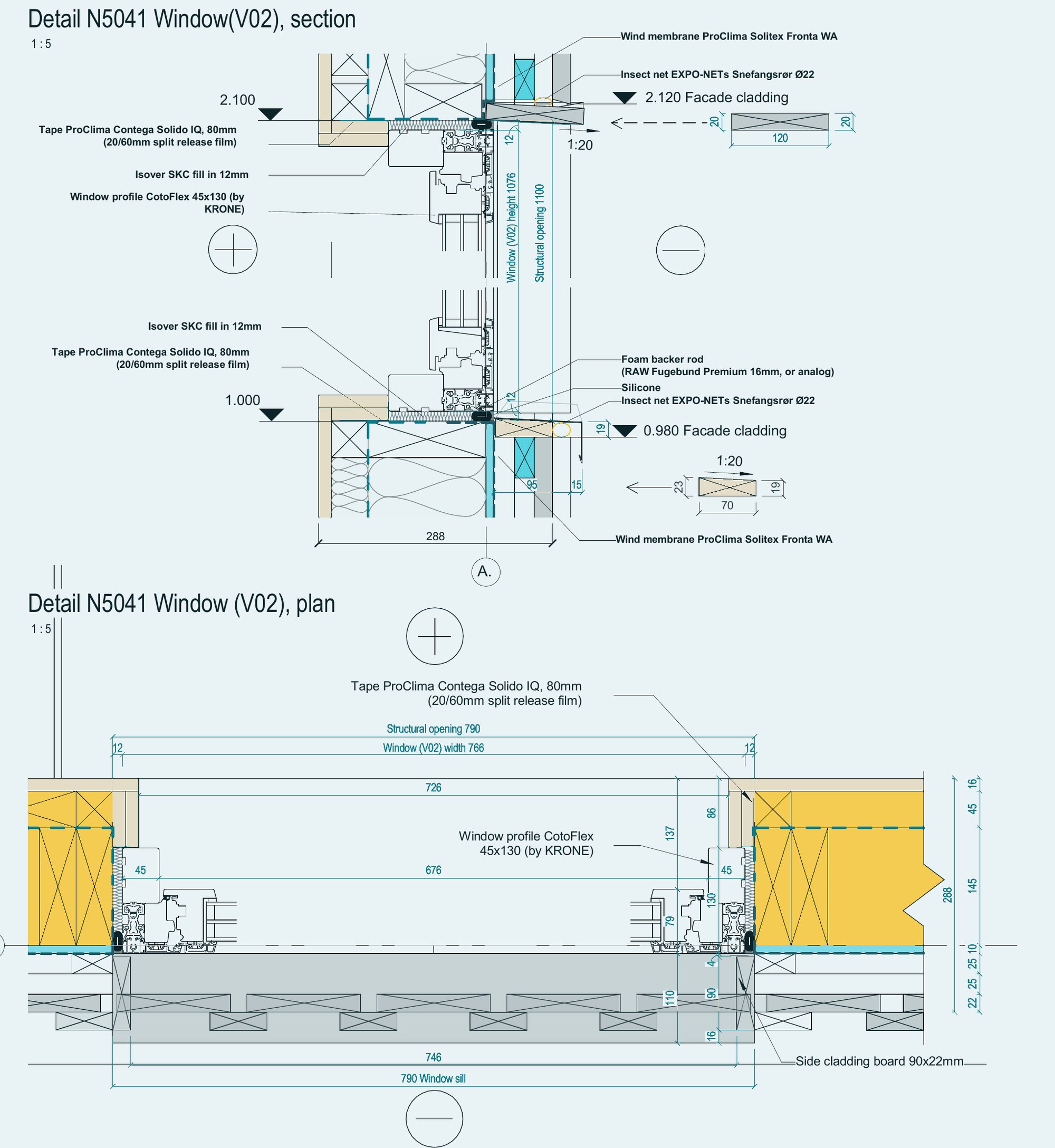

Panels are only as good as the joints between them. These are the fabrication details issued with the house: the wall build-up, the panel joint, the roof edge, the floor joint and the window. Press play to step through them.

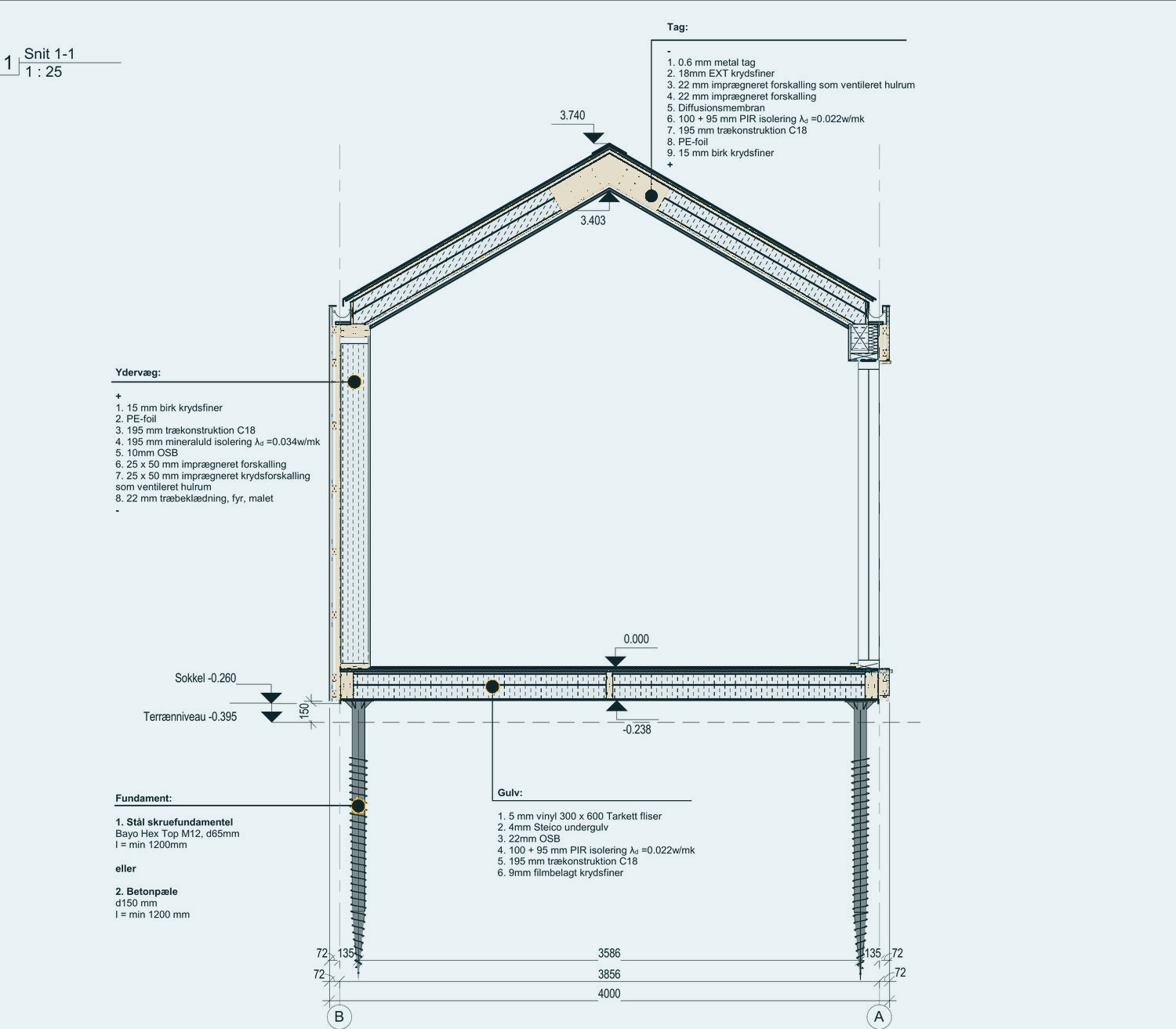

1 / 5

Wall build-up

288 mm external wall: 22 mm cladding, battens, wind membrane, 9.5 mm gypsum board, 145 mm frame with insulation, vapour barrier

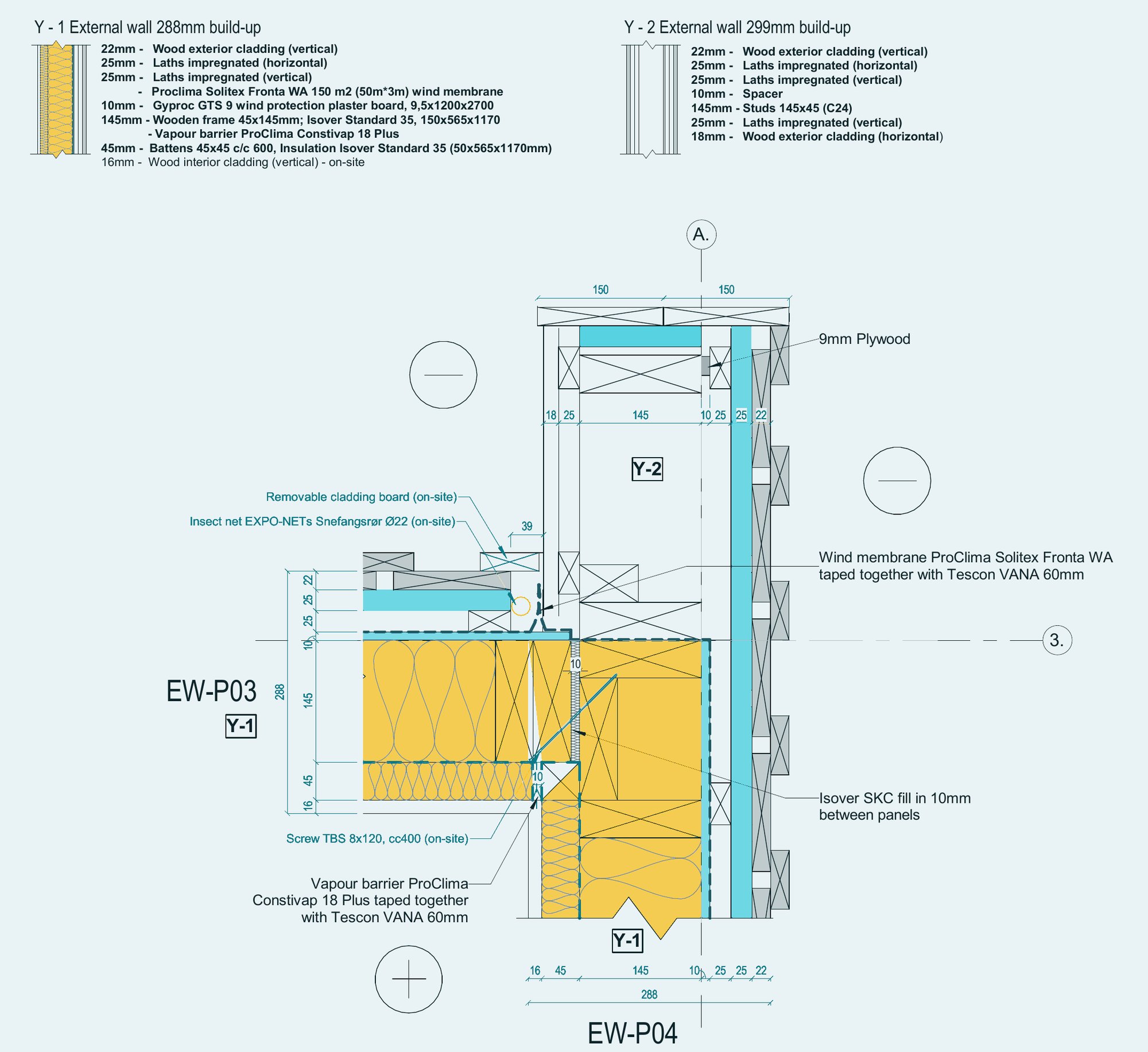

Detail N5014 · panel corner EW-P03 / EW-P04 · 1:5
External wall
288 – 299 mm
Floor
317 – 326 mm
Roof

467 mm

Internal wall
147 mm

The rest of the kit: floors, internal walls, roof.

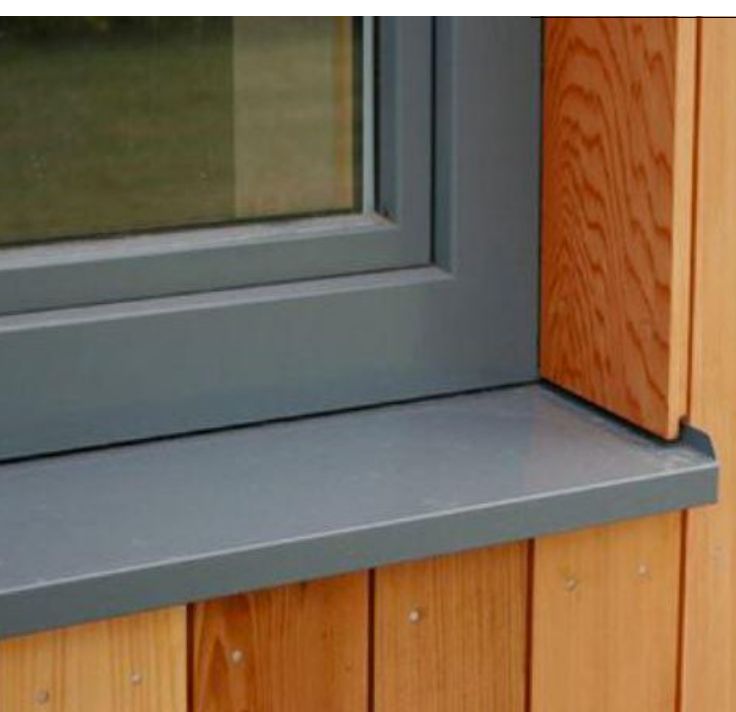

Window trim on site · Kettingskov
Window trim on site · Kettingskov
Eight Als homes from the air
Kettingskov · Denmark · 2022

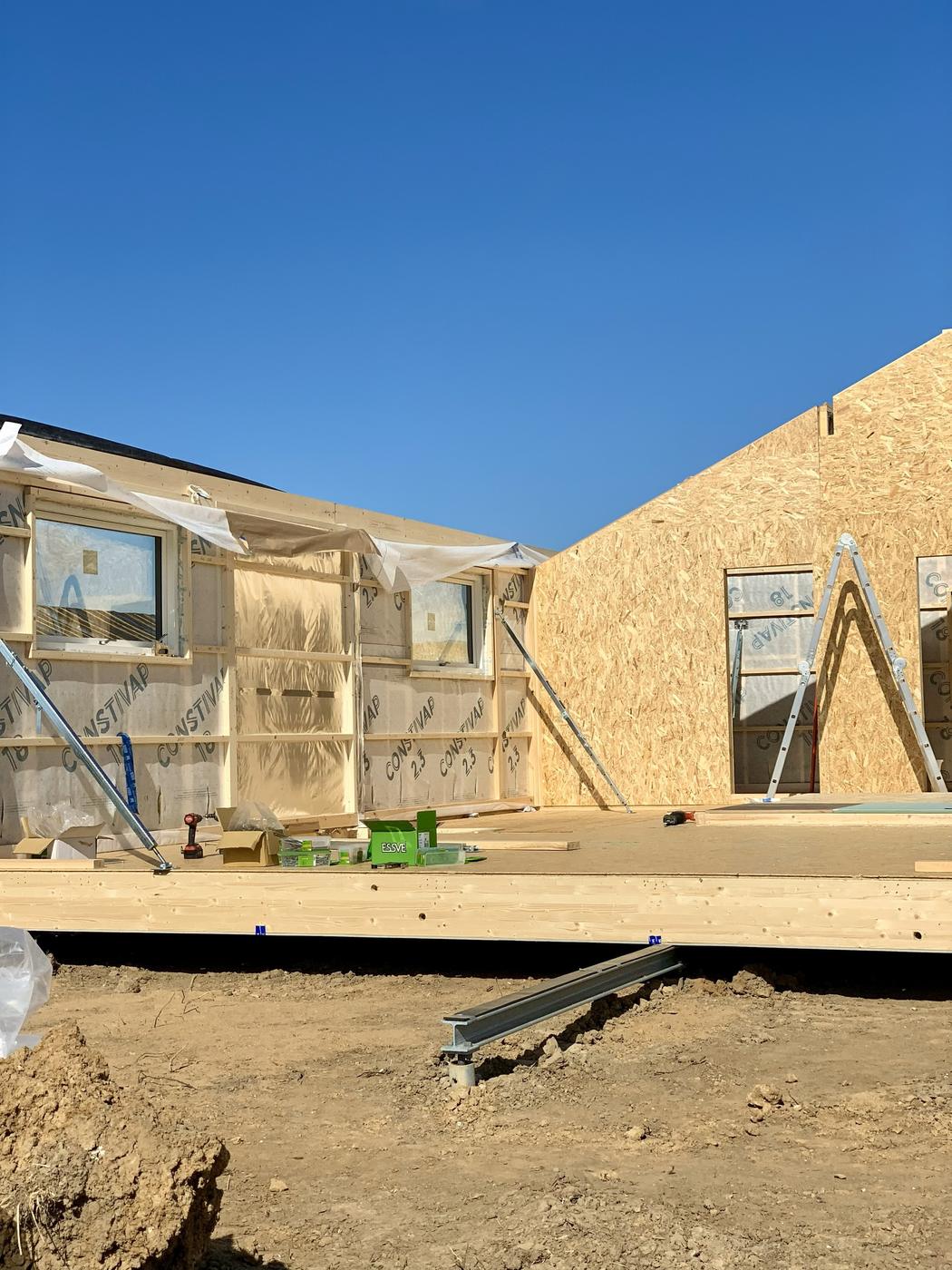

Panels craned into place
Panels craned into place
Timber frame and glass gable
Timber frame and glass gable
Case 04 · Categories 1 and 2 · Residential · 2022

Two apartment sizes from one module bay.

Modular apartments · Denmark

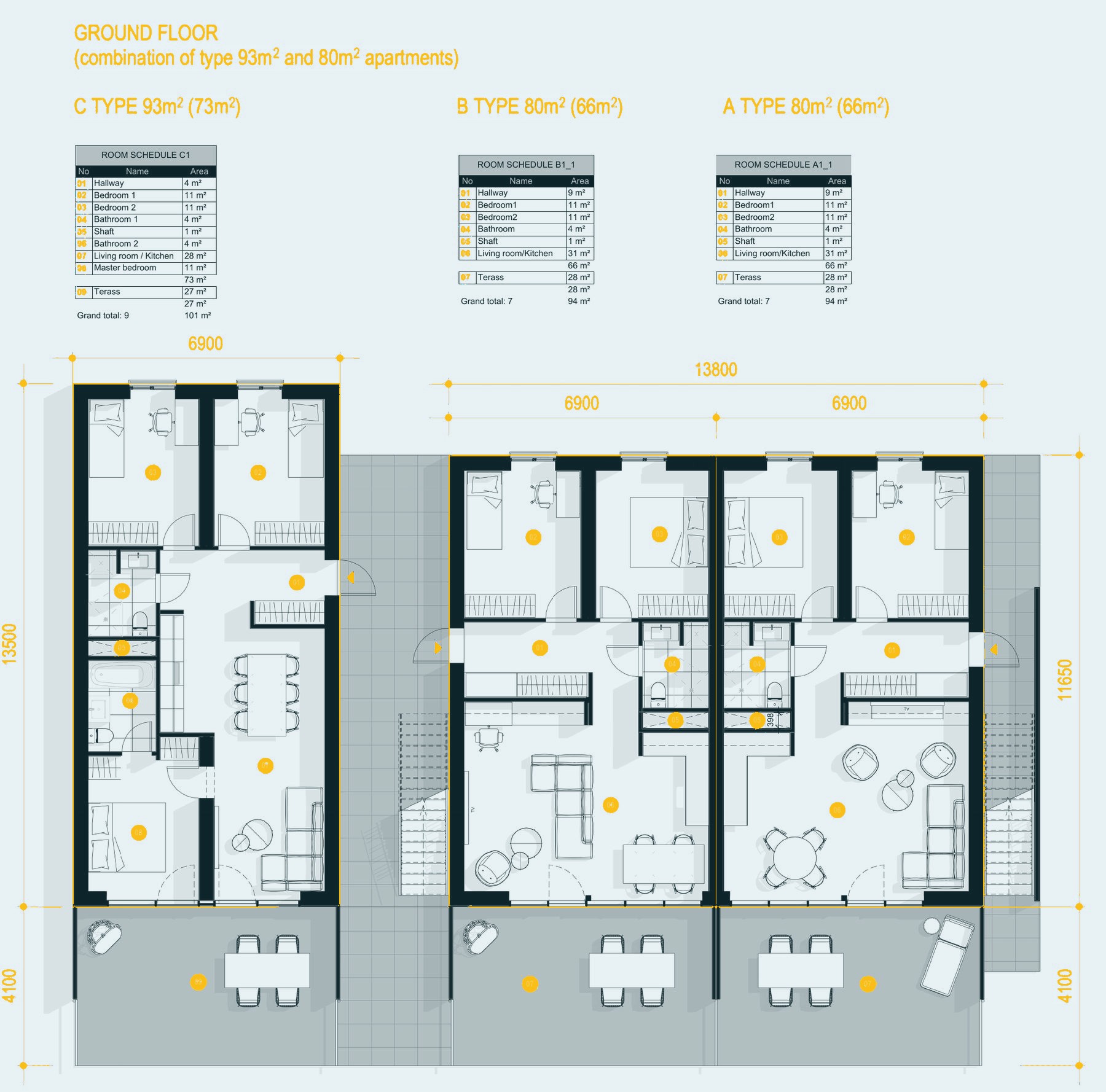

Two-storey apartment buildings with gallery access. The 93 m² and 80 m² homes are both built from 6.9 m module bays, so one set of modules, one facade system and one stair detail serve the whole scheme.

C type
93 m² · 3 bedrooms
A and B types
80 m² · 2 bedrooms
Module bay
6 900 mm
Clear height
2 600 mm
Case 05 · Feasibility · Residential · 2021

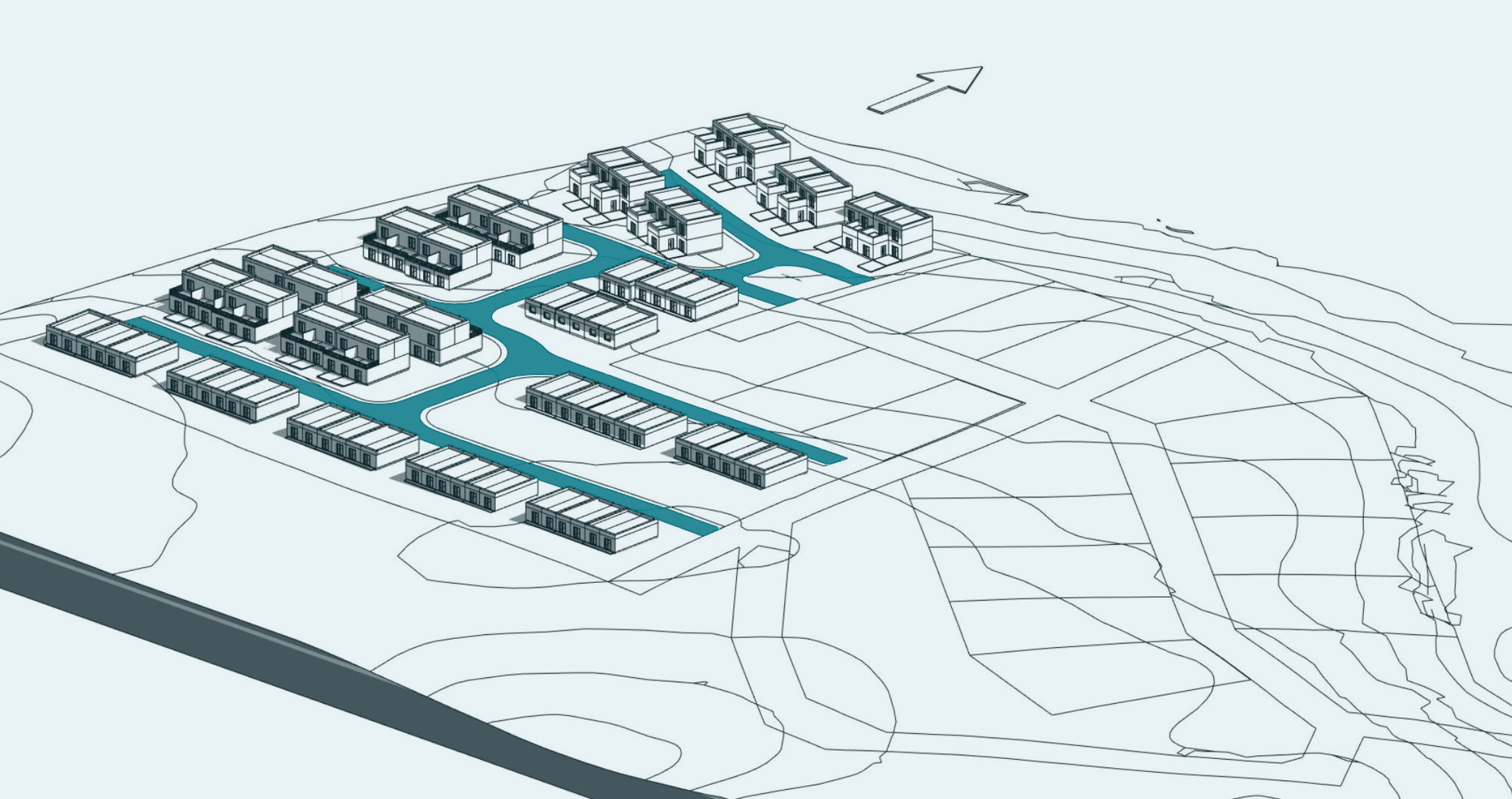

A village of 62 modular homes on a sloping site.

Kolding · Denmark

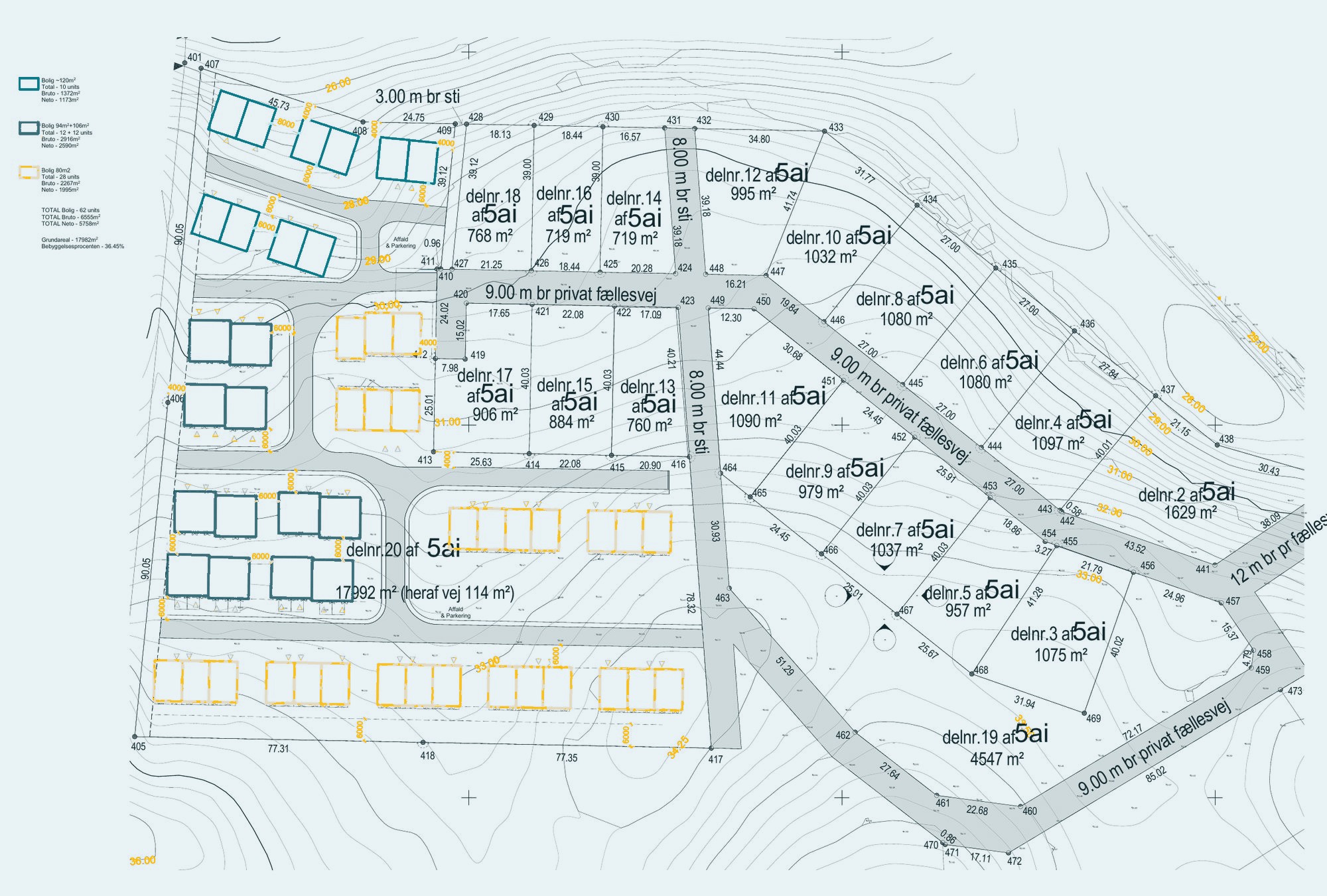

Before a factory can quote, the scheme has to become modular. We laid out 62 homes in four sizes on a 17 982 m² site, with paths, waste and parking, and drew each home on a grid of factory modules.

Homes
62
Site
17 982 m²
Gross area
6 555 m²
Plot ratio
36.45 %

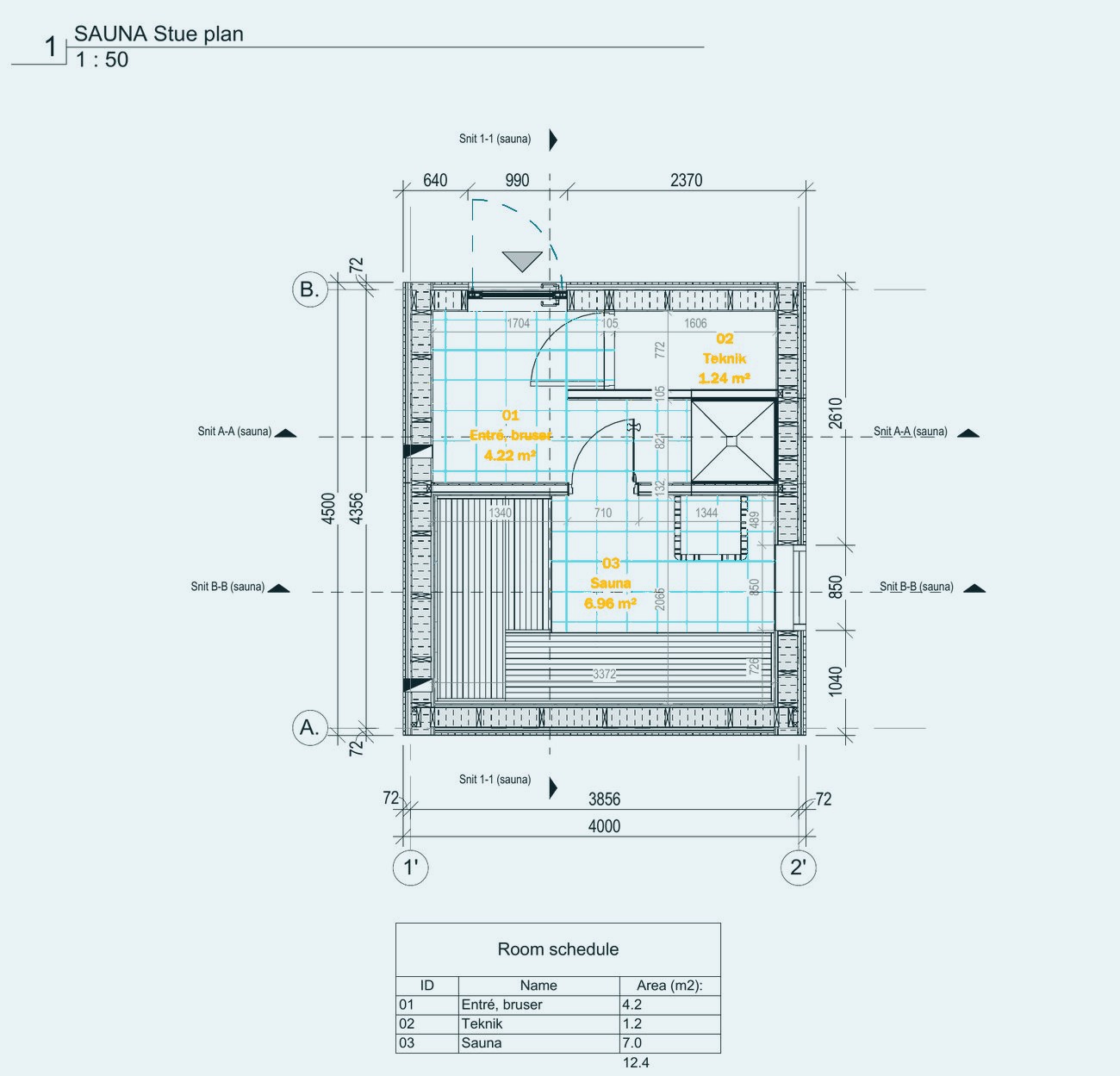

Case 06 · Category 1 · Living and sauna PODs · 2022

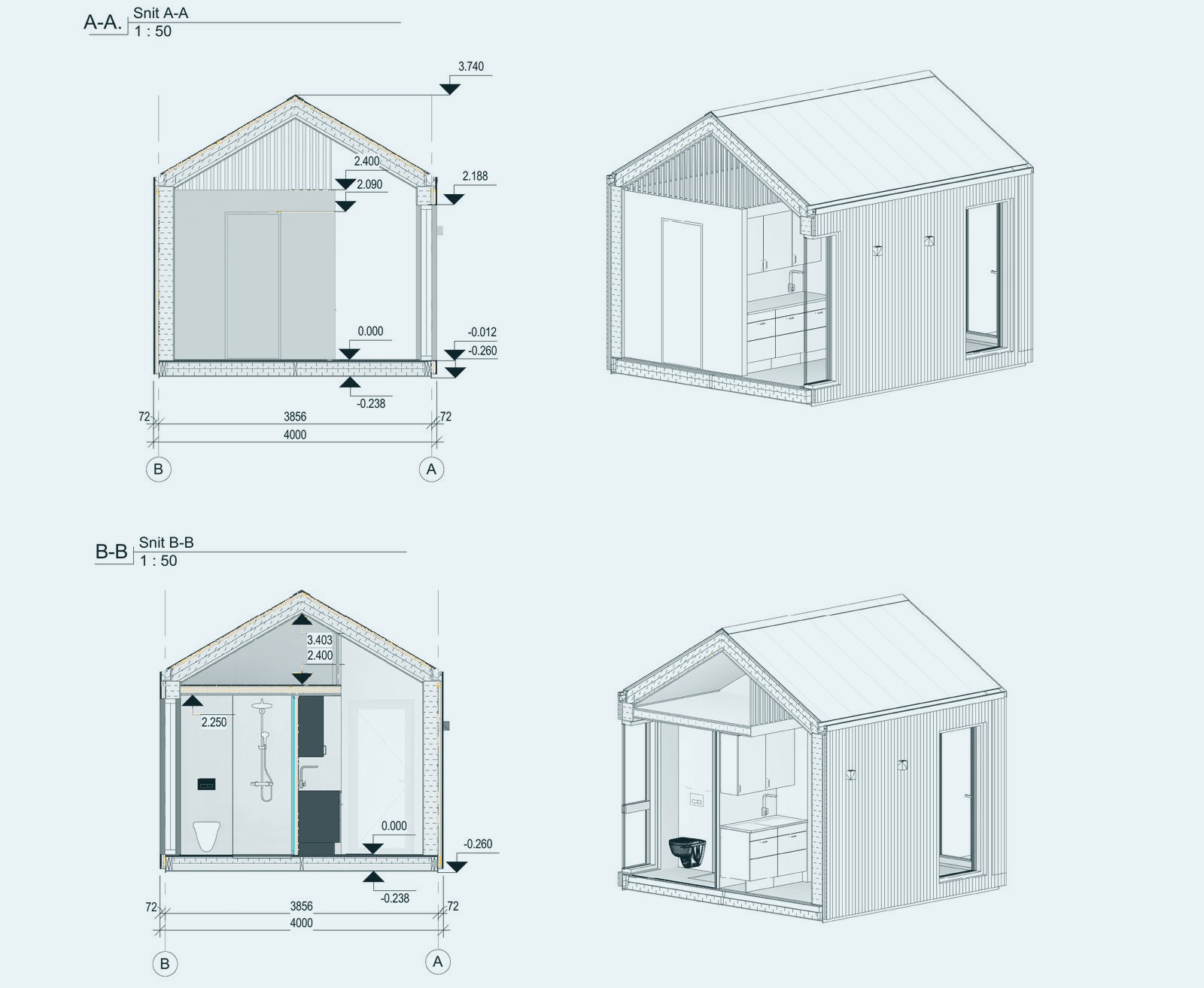

Two boxes, seven layouts.

Modular annex PODs · Denmark

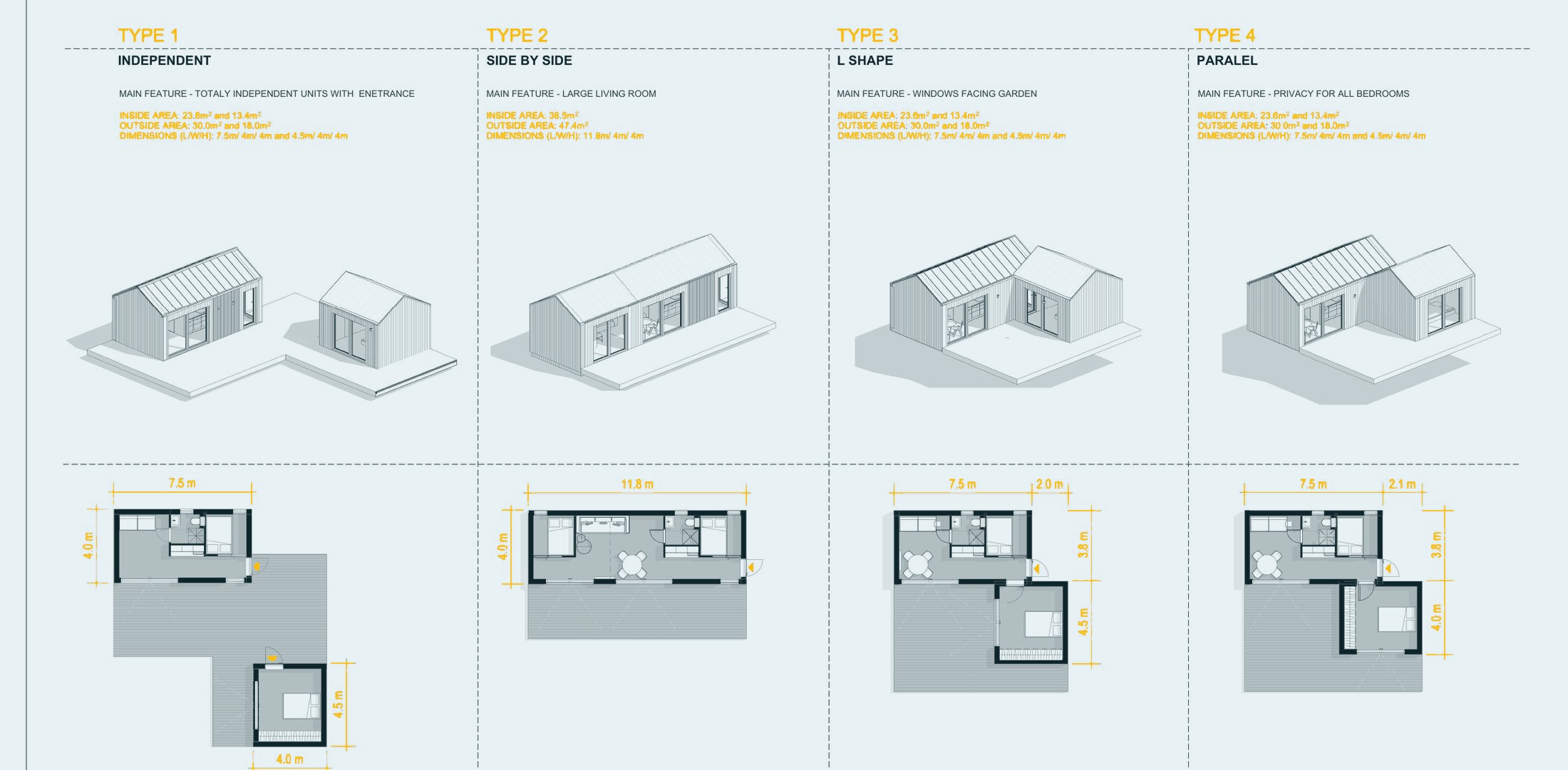

A 7.5 m and a 4.5 m living POD, both 4 m wide, combined independently, side by side, as an L, in parallel, or joined by a glass hallway or a pergola. A sauna POD and a one-room POD share the same timber chassis and screw-pile foundation.

Living PODs
7.5 × 4 m · 4.5 × 4 m
Inside area
23.6 + 13.4 m²
Sauna POD

4.5 × 4 m · ridge 3.74 m
Wall · roof · floor
314 · 278 · 244 mm
What we deliver to other businesses

Six disciplines, checked against the factory.

We work for manufacturers, contractors and developers as their design team for the offsite part, or alongside their own designers as the people who know what a factory needs.

Production

Design for manufacture and assembly.

  • Shop and production drawings per type
  • BOM and BOQ from the model
  • Panel and module splits, joints, lifting
  • Assembly sequence on site

Structural

Load paths that survive transport and stacking.

  • Module stacking and transfer
  • Timber frame and steel module coordination
  • Deflection limits per element
  • Wind, snow and seismic inputs

Technical

Fire, sound, heat and air.

  • REI and EI ratings per element
  • Acoustic build-ups between units
  • U-values and air tightness
  • National standards: DK, IS, LV

Architectural

Types that repeat and still feel designed.

  • Type and subtype libraries
  • Room data sheets and interiors
  • Plans, ceilings, elevations, tiling
  • Facade and roof interfaces

HVAC and MEP

Services built into the element, not chased into it.

  • Pipe and duct routes inside walls
  • Connection points to the building
  • Sprinkler, ventilation, drainage openings
  • Clearance above and around pods

Design management

The process that keeps many actors on one set of numbers.

  • BIM execution plan and naming
  • Common data environment, IFC exchange
  • RFI and change registers
  • Self-checklists and issue registers
MMD · Modern methods of design · with Frest Consult

Large projects fail between people, not inside one drawing.

A hospital POD passes through a client, a contractor, a factory and four design disciplines before it is built. MMD is how we design across all of them with AI-assisted tools. The method comes from Frest Consult, our AI subsidiary, and its ring and string approach.

ONE STRAND · ONE RECURRING TASK THE RING human judgement ClientContractorFactoryArchitectureStructureMEP Room data → BOQ checkPanel layout in RevitType variant compareRFI triage by discipline STRINGS · TOOLS THAT RUN ON THEIR OWN
Human approval on every outputThe tools draft, compare and check. The project team decides, signs and issues.
Local where it mattersModels run on your own machines when the data is sensitive. The cloud only when you allow it.
Built for your team, then handed overEach tool is shaped around one recurring task and left with the people who use it. More at frestconsult.com.
Working with us

Four ways in, from one review to the whole design.

01weeks

Offsite review

We read your scheme and tell you what a factory will struggle with: grids, spans, services, transport sizes, repeatability.

02per type

Type design

Pods, modules or panels designed type by type, from room data to production drawings, in your BIM process.

03embedded

Design management

We run the BEP, registers and coordination between client, contractor, factory and disciplines.

0412 weeks

MMD pilot

One recurring design task in your team turned into a tool with Frest Consult, then handed over.

Talk to the team

Bring us a scheme, a type list or a factory question.

Send drawings, a room data sheet or just a site and a unit count. We reply with what we would do first.

WRITE TO info@frest.lv
fresthomes.com
